Process · Topic 7 of 12

Earned Value Management

Master the earned value formulas PV, EV, AC, CV, SV, CPI, SPI, EAC, ETC, VAC and TCPI with a worked example and guidance for choosing the right EAC.

  • 5 min
  • Includes a diagram
In a nutshell
  • CV = EV - AC and SV = EV - PV, with positive meaning good.
  • CPI = EV / AC and SPI = EV / PV, with above 1 meaning good.
  • EAC = BAC / CPI when current cost performance continues.

What it is

Earned value management (EVM) measures project performance by comparing three things: what you planned to do, what you actually did and what it cost. It combines scope, schedule and cost in one set of numbers, so you can tell objectively whether a project is ahead or behind and over or under budget.

It is mainly a predictive technique, although the ideas can be applied to agile work with release or story point based measures.

Planned valuePV work plannedEarned valueEV work doneActual costAC money spentVariances and indicesCV SV CPI SPIForecastEAC ETC VAC TCPI

How it works

The three inputs

TermMeaning
BAC (budget at completion)Total approved budget for the work
PV (planned value)Budget for the work scheduled to be done by now
EV (earned value)Budget for the work actually completed by now
AC (actual cost)Real cost of the work done by now

EV is measured in budget terms, not in money actually spent. Percent complete is EV divided by BAC.

Variances and indices

MeasureFormulaPositive or above 1 means
Cost variance (CV)EV - ACUnder budget
Schedule variance (SV)EV - PVAhead of schedule
Cost performance index (CPI)EV / ACGetting more value than money spent
Schedule performance index (SPI)EV / PVProgressing faster than planned

A memory aid is that EV always comes first in the formula. A negative variance, or an index below 1, is bad. Indices of exactly 1 and variances of zero mean on plan.

Forecasting

The estimate at completion (EAC) is the forecast final cost. The formula depends on the assumption you make about future performance.

SituationEAC formula
Past variance is typical and will continueBAC / CPI
Variance was a one off, and the rest goes to planAC + (BAC - EV)
Both cost and schedule performance affect the restAC + (BAC - EV) / (CPI x SPI)
The original estimate is no longer validAC + new bottom up ETC

Then the remaining measures follow.

MeasureFormula
Estimate to complete (ETC)EAC - AC (or a fresh bottom up estimate)
Variance at completion (VAC)BAC - EAC
TCPI to meet BAC(BAC - EV) / (BAC - AC)
TCPI to meet EAC(BAC - EV) / (EAC - AC)

The to complete performance index (TCPI) shows the cost efficiency required on the remaining work. A TCPI above 1 means the team must perform better than so far, and a figure far above 1 suggests the target is unrealistic.

Worked example

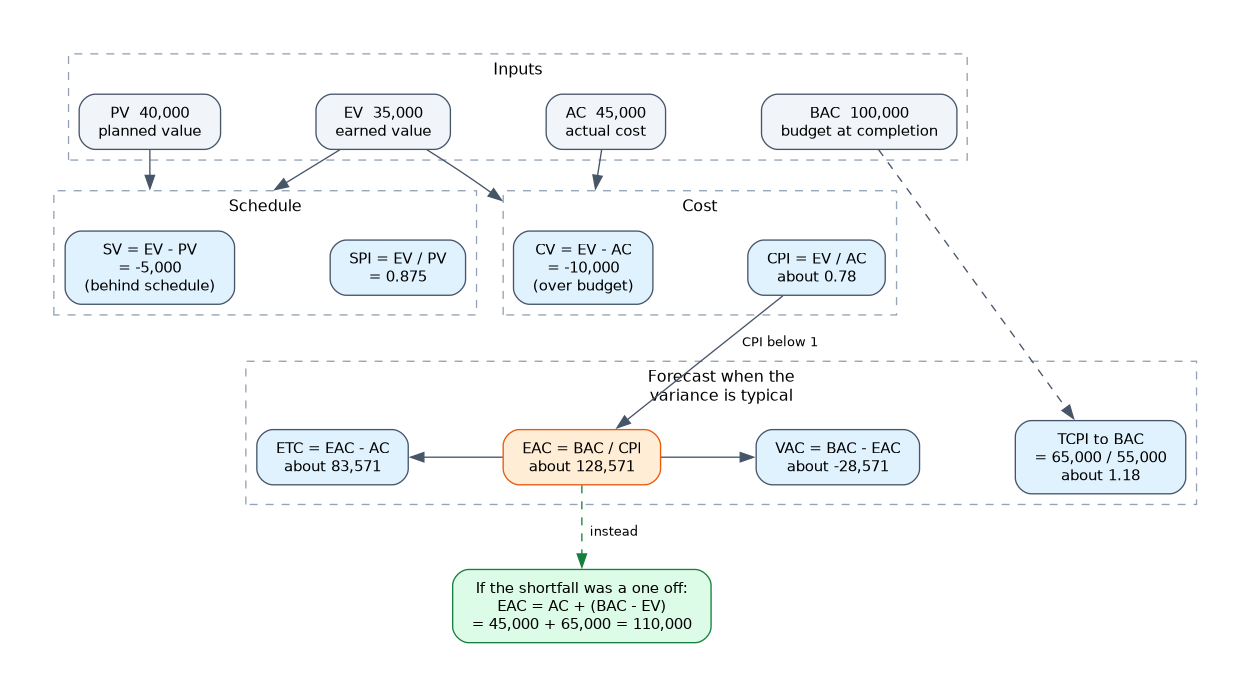

The worked earned value example: PV, EV, AC and BAC feed the schedule measures SV and SPI and the cost measures CV and CPI, and CPI then drives the EAC, ETC, VAC and TCPI forecasts, with the one off EAC of 110,000 shown as the alternative. Suppose BAC = 100,000, PV = 40,000, EV = 35,000 and AC = 45,000.

MeasureCalculationResult
CV35,000 - 45,000-10,000 (over budget)
SV35,000 - 40,000-5,000 (behind schedule)
CPI35,000 / 45,000about 0.78
SPI35,000 / 40,0000.875
EAC (typical)100,000 / 0.7778about 128,571
ETC128,571 - 45,000about 83,571
VAC100,000 - 128,571about -28,571
TCPI to BAC65,000 / 55,000about 1.18

If the shortfall was a one off, EAC = 45,000 + 65,000 = 110,000 instead. The choice of formula is a judgment stated in the question, so read for clues such as "will continue at the current rate".

CPI below 1over budgetTypical variancecontinuesEACBAC divided by CPI

Reading the picture

SV is measured in money terms and loses meaning at the end, because EV and PV both reach BAC. SPI behaves better late in the project. Plot PV, EV and AC as S curves over time to see trends: EV below PV means behind, and AC above EV means overspending.

Using EVM in agile and hybrid work

Agile projects use burndown, burnup and velocity to show progress, but earned value ideas still apply when budget, release scope and time are tracked. For a hybrid project, EV can be calculated on the predictive parts.

Exam tip

Write the formulas as CV and SV first (subtract), then CPI and SPI (divide), keeping EV first every time, and check the sign of the result against the story in the question.

What to remember for the exam

  • CV = EV - AC and SV = EV - PV, with positive meaning good.
  • CPI = EV / AC and SPI = EV / PV, with above 1 meaning good.
  • EAC = BAC / CPI when current cost performance continues.
  • EAC = AC + (BAC - EV) when the variance is atypical.
  • EAC = AC + (BAC - EV) / (CPI x SPI) when cost and schedule both drive the rest.
  • ETC = EAC - AC, and VAC = BAC - EAC.
  • TCPI = (BAC - EV) / (BAC - AC) to meet BAC, or (BAC - EV) / (EAC - AC) to meet EAC.
  • Percent complete = EV / BAC.
  • Read which assumption the question gives before choosing an EAC formula.

Common mistakes

Subtracting in the wrong order. CV is EV minus AC, and getting it backwards flips the meaning.

Dividing the wrong way. CPI is EV over AC, not AC over EV.

Using AC as earned value. Money spent is not progress, and EV is the value of the work completed.

Picking the wrong EAC. If the question says the problem will not recur, use the atypical formula.

Reading a good SV at the end as success. SV drifts to zero when work is finished, even if the project was late.

Watch out

Do not confuse the TCPI denominator. For BAC it is BAC minus AC, and for EAC it is EAC minus AC.

Check yourself

  • What is the cost performance index if EV = 80 and AC = 100?

    CPI = 80 / 100 = 0.8, which means over budget.

  • Which EAC formula applies when the current variance is expected to continue?

    EAC = BAC / CPI.

  • What does VAC tell you?

    The difference between the original budget and the forecast final cost, calculated as BAC - EAC, where a negative value means an overrun.
